Vibratory casing installation in Portage Bay schedule: Phase of work is complete

Date: May 2026 to mid-summer 2026 (at least)

Time: Between 7 a.m. and 10 p.m. on weekdays and 9 a.m. to 10 p.m. on weekends

Activity details:

High-impact construction

Impact type:

DaytimeNoiseVibration

July 27, 2026 Update:

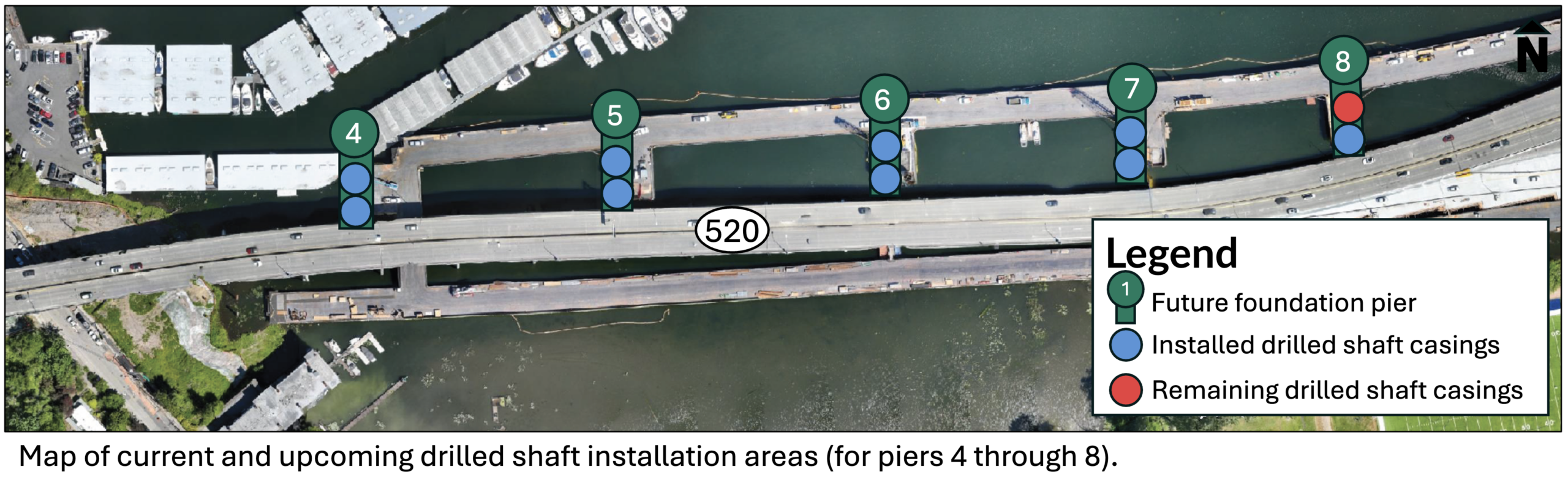

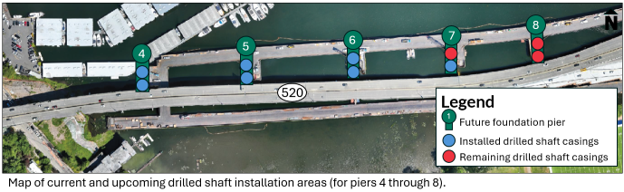

Crews have finished installing the steel casings into Portage Bay for piers 4 through 8 of the new westbound bridge (casing installation for piers 1-3 and 9-12 will be scheduled in the future). Crews are now shifting their efforts to installing rebar and pouring concrete. This page will not be updated again until more vibratory work for casing installation resumes. Please call our 24-hour construction hotline at 206-319-4520 if you have questions on this or any other project-related work.

Crews are now using vibratory hammers to install large diameter steel casings in Portage Bay. This work is helping build the new foundations for the future westbound Portage Bay Bridge.

Crews started this work on the northwest side of the temporary work trestle near Boyer Avenue East and will work back and forth between casings, moving east toward Montlake Boulevard.

Below is an update on the planned schedule of vibratory casing installation in Portage Bay. This schedule will be updated weekly and is meant to provide a general overview of planned work. Please note construction schedules can – and often do – change so please check this link regularly for potential updates.


Installation schedule for the week of

  • Vibratory casing installation for these piers is complete.


Nearby neighbors will experience noise and vibration during daytime construction through mid-summer. After crews finish installing the casings, they will begin work on the drilled shafts.

Typical work hours: 7 a.m. to 10 p.m. weekdays and 9 a.m. to 10 p.m. on weekends
